Energy
In just 30 hours, 2,000 cubic metres of concrete were poured into the Paks foundation slab
Whilst the review of the Paks expansion project – which will create an additional 2,400 megawatts of capacity – is still ongoing, construction is continuing with a view to ensuring business continuity, according to the project’s website.

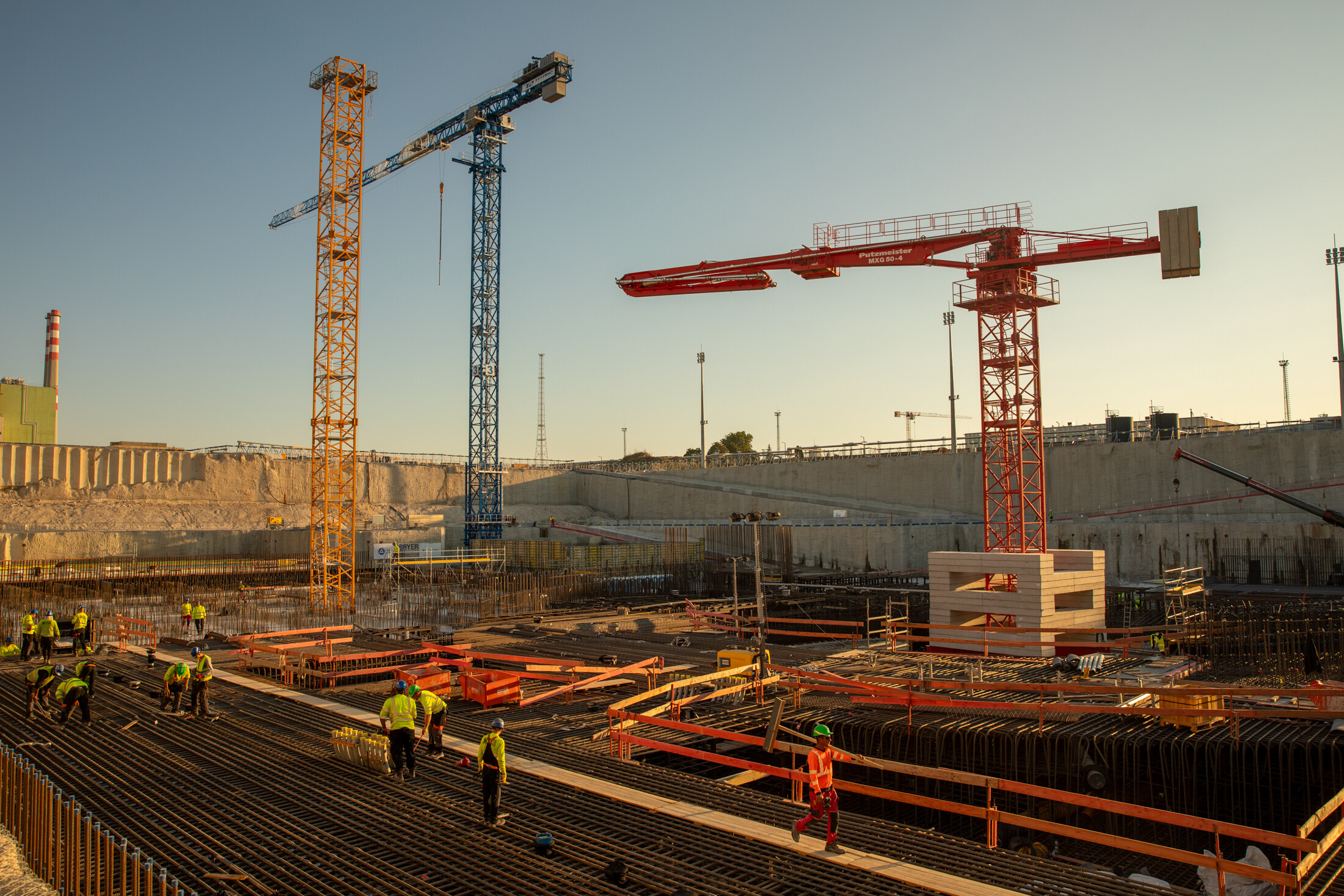

The report provided details of the foundation slab forming the base for the five buildings on the Unit 5 nuclear island. According to the report, the concrete work for the foundation slab, which is on average three metres thick, is being carried out in stages. During the most recent construction phase, in the second week of September, work continued uninterrupted for 30 hours.
During the operation, which took place in two shifts and involved 180 specialists, 2,010 cubic metres of basalt concrete mix of strength class C35/45 were poured into the foundation slab using twenty mixers. The concreting was preceded by the installation of 670 tonnes of reinforcing steel.
In addition to all this, the scope of the works includes, amongst other things,
- the construction of the construction and assembly base,
- The construction of the Oktató- és Szimulátorközpont
- and the excavation of the construction pit for Block 6 to the design level, more than 90 per cent of which has been completed.
Source: Link
-
Kirakat 2026. 10. 01.
A leading machinery distributor in the construction and haulage sectors is building a new service centre and extending its existing premises
-
Industry news 2026. 10. 02.
Hungary has joined the single electricity market
-
Railway development 2026. 09. 29.
The railway line leading to the Hungarian border is also set to be upgraded as part of Croatia’s large-scale development programme
-
Current at 2026. 09. 30.
It’s being built at full speed and could be the saviour of our domestic energy security – what is it?
